US 6 Palisade Intersection Improvements
About the Project
This safety improvement project on US 6 in Palisade, Colorado (MP 42.45 to 43.01, Rupp Avenue to Iowa Avenue) includes:
- Reconstructing the US 6/Elberta Avenue intersection into a concrete modern roundabout
- Re-configuring the US 6/Iowa Avenue intersection
- Constructing sidewalks between Rupp and Iowa Avenues
- Modifying or eliminating existing frontage roads, including converting two-way frontage roads to one-way to improve multi-modal access (bicycles and pedestrians)
- Anticipated reconstruction of approximately 500 feet of US 6 near the Elberta Avenue intersection
Other significant improvements include storm drain, water quality and signing and pavement marking improvements.
Work this Week & Lane Closures for US 6 Palisade Intersection Improvements
Project Facts
- Construction Cost: $7.1 million
- Contractor: KSK LLC
- Timeline: January 2026 to October 2026
- Location: US 6
- Nearest Town/City: Palisade
- Mile Point(s): MP 42.45 to MP 43.01
- County: Mesa
Project Benefits
- Improve safety and operational concerns with the existing configuration of US 6 and the following frontage road intersections due to their close proximity to each other:
- Rupp Avenue (37 1/10 Road)
- Elberta Avenue
- Iowa Avenue
- Improve traffic flow
- Significantly reduce intersection wait times by minimizing or eliminating stops
- Increase safety
- Reduce severe crashes by eliminating left turns across traffic
Work Schedule
- Work is expected to be completed late 2026
- Work hours will be Monday to Friday from 7 a.m. to 7 p.m.
- January to Late March - Preparation for construction includes:
- Rerouting irrigation
- New storm inlets to aid drainage
- Clean culverts
- Grading for storm water drainage improvement
- Detour installation
- April to Mid June - Westbound roundabout construction on US 6 includes:
- Roundabout concrete installation, north side of US 6
- Asphalt paving on the first level
- Mid June to Early September - Eastbound roundabout construction on US 6 includes:
- Roundabout concrete installation, south side of US 6
- Asphalt paving on the first level
- September to Late Fall - Final work includes:
- Concrete installation to tie Elberta Avenue to US 6 and for business approaches
- Asphalt paving on the final level
- Striping and signage installation
- Pedestrian crossing installation

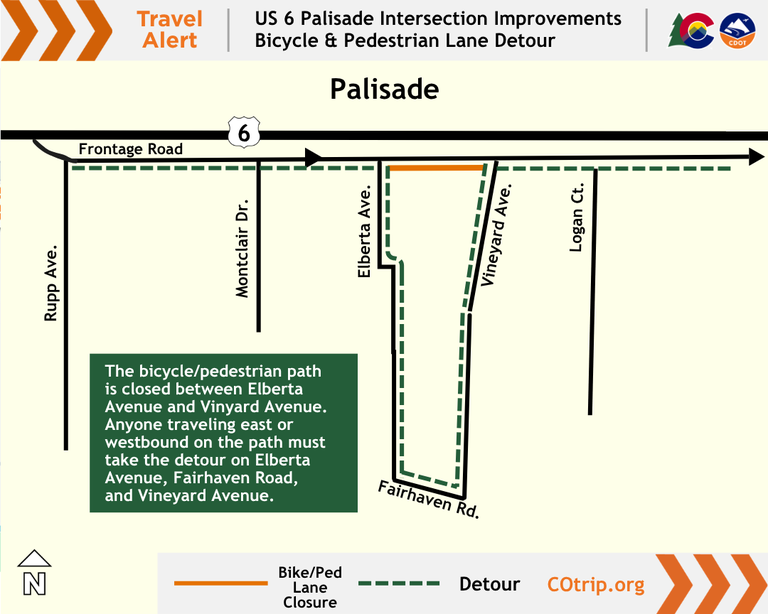

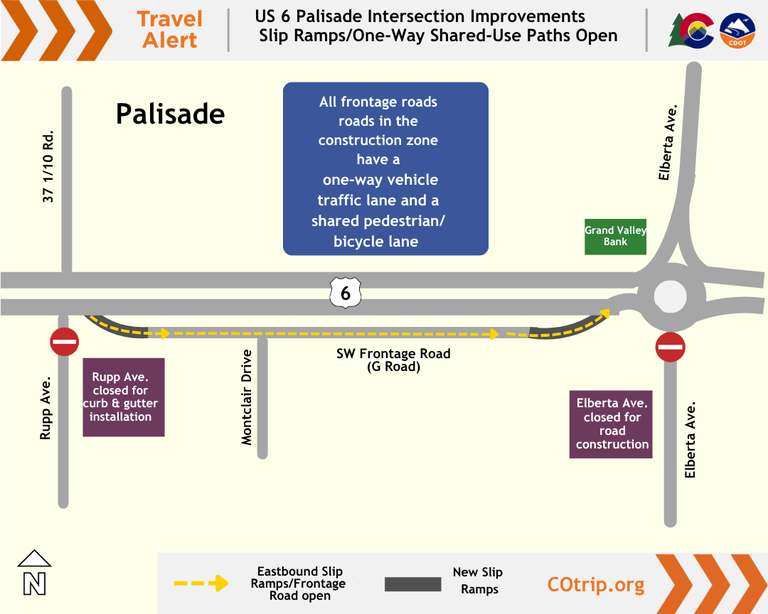

Traffic Impacts
- During some phases of construction, full road closures with detour routes will be in place
- Business access will remain open
- Please be aware of construction vehicles. entering and exiting the work area
- Refer to COtrip.org for real-time travel conditions and road closures
