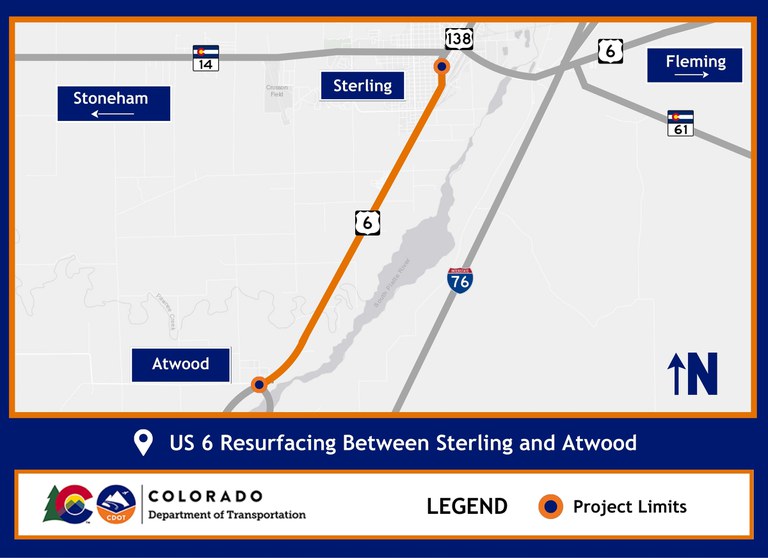

US 6 Resurfacing Between Sterling & Atwood
Project Update | US 6 Resurfacing project pauses for winter through spring 2027
Motorists can anticipate intermittent lane closures for roadway maintenance throughout winter shutdown.
About the Project
CDOT and contractor Harper Brothers Construction began a resurfacing, bridge replacement and roadway improvement project on US Highway 6 between Sterling and Atwood from Mile Point 398 to 405. The expected completion date is now October 2027.
During the 2026 construction season, crews replaced the concrete roadway on the eastbound lanes. In addition, new guardrail and permanent signs were installed. The eastbound US 6 bridge over Sterling Lateral No. 1, located north of County Road 24 and south of Sterling, was replaced along with its canal structure. Work on the Pawnee Creek Bridge included deck repairs and guardrail replacement.
CDOT identified issues with the placement and alignment of reinforcing steel within the concrete pavement. Corrective work is necessary to ensure the completed roadway meets CDOT’s standards for long-term durability and quality. CDOT and the contractor will work together over the winter months to determine the appropriate corrective actions.
The full corrective work required on portions of the eastbound US 6 lanes could not be completed before winter and will continue during the 2027 construction season. Before the shutdown, crews will address the condition of the existing westbound lanes and complete the work necessary to return traffic to its normal configuration for the winter.
The project is anticipated to resume in early spring 2027 to complete corrective work on the eastbound lanes and resurface the westbound lanes. In addition, the frontage roads adjacent to US 6 will be resurfaced. Following the Pawnee Creek bridge deck repairs and US 6 resurfacing work, crews will begin concrete paving operations on South Division Avenue. South Division Avenue will be fully closed between Park Street and Delmar Street. During the closure, crews will complete storm sewer upgrades and improve curbs, gutters, and sidewalks medians. The existing concrete-lined ditch will be removed and replaced with an underground pipe to improve drainage.
Final improvements along US 6 include the installation of new roadway signage and pavement markings, in addition to a new road-closure gate and LED Luminaire to enhance safety and visibility for all travelers.
Work this Week & Lane Closures for US 6 Resurfacing
Project Facts
- Construction Cost: $20 million
- Contractor: Harper Brothers Construction
- Timeline: March 2026 to fall 2027. Winter shutdown scheduled November 2026 through spring 2027
- Location: US 6
- Nearest Town/City: Sterling and Atwood
- Mile Point(s): MP 398 to MP 405
- County: Logan
Project Benefits
- Upgraded bridges provide a safer, smoother and more dependable route for daily commuters and freight traffic
- Bridge deck repairs prevent further deterioration, helping the bridge last longer without the need for full replacement
- Preventative maintenance extends the lifespan of the roadway by removing the worn surface through milling and restoring smoothness and safety with a fresh asphalt overlay
- Guardrails will be upgraded to prevent vehicles from leaving the roadway, reducing the severity of crashes and minimizing the risk of injuries and fatalities
- New signage ensures motorists receive accurate directions, speed limits and warnings, improving safety and reducing driver confusion
Work Schedule
- Daytime work hours are from sunup to sundown Monday through Friday
- Possible weekend work may occur
- Work schedules may be impacted by weather and other unanticipated delays
Traffic Impacts
Winter Maintenance
Motorists can expect the following impacts along US Highway 6 between Sterling and Atwood (Mile Points 398 to 405) during winter shutdown, from November 2026 through spring 2027:
-
Intermittent lane closures in both directions will allow crews to perform concrete testing and roadway maintenance
-
The speed limit is reduced to 55 mph
-
Work schedules and traffic impacts will be shared as needed
2027 Traffic Impacts
When construction resumes in 2027, motorists can expect the following impacts along US 6 between Sterling and Atwood (MP 398 to MP 405):
- Motorists can expect head-to-head traffic and traffic shifts with one lane in each direction
- Access to county roads and driveways along US 6 may be limited during paving operations
- The speed limit will be reduced to 55 mph
- A 12-foot width restriction will be in place
- Motorists should watch for flaggers directing traffic
- Motorists should watch for construction vehicles entering and exiting the work area
- Slow down and use caution through the work zone to help keep crews and the traveling public safe
- For current road conditions, visit COtrip.org
