CO 7 Multimodal Corridor from Brighton to Boulder
About the Project
Colorado Department of Transportation, Regional Transportation District (RTD) and local agencies are working on a planning initiative along CO 7 to improve traveler safety, make your trip more efficient and improve access to multimodal travel opportunities between Brighton and Boulder.
Through a $10 million Regional Share Funding grant from the Denver Regional Council of Governments, priority projects are being identified and early design plans developed to encourage quick investment in the transportation improvements amongst the municipalities, counties, agencies and developers along the corridor.
Schedule & Important Dates
- February 2025: Segment E to M Project Update Video
Segments
The limits of the project extend approximately 22 miles through eight local agencies. The decision to separate the corridor into segments was determined by the CO 7 - Corridor Development Plan (CDP). This is to maintain efficient implementation of design recommendations that are tailored to the needs of each segment.
Previous documentation efforts that have been completed and supplemental information can be found in the segment links below:
- Segment A: 28th Street to 63rd Street
- Segment B: 63 Street to US 287
- Segment C: US 287 to 119th Street
- Segment E to M: County Line Road to US 85

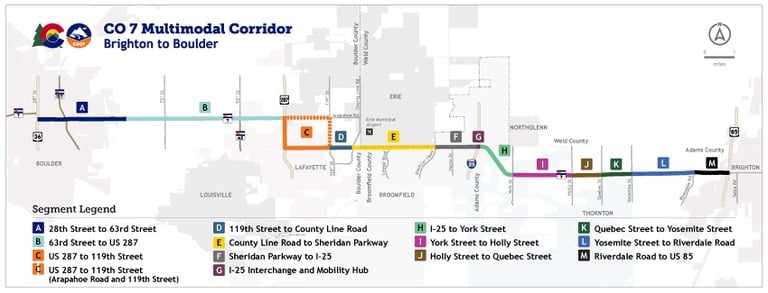

The Corridor Development Plan originally identified 13 segments to help plan and design improvements with defined endpoints. However, as planning shifts toward a corridor-wide approach, the emphasis on individual

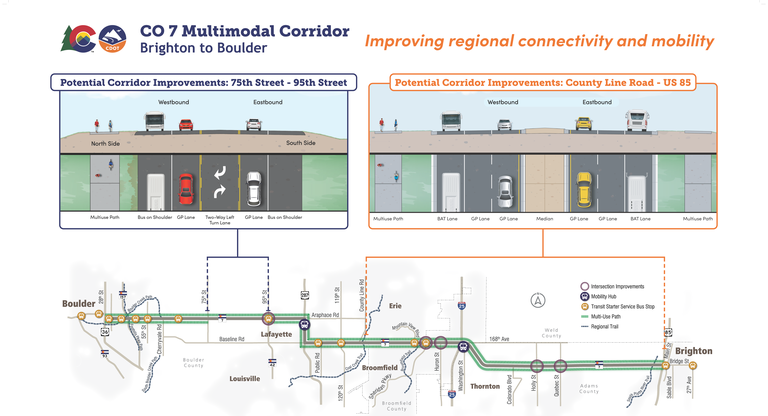

segments has become less critical. The map below shows a continuous corridor with typical sections, transit starter service locations, trail connections, and mobility hubs.
To provide multimodal transportation improvements to optimize regional connectivity and mobility between eight jurisdictions, including three counties, in this rapidly growing and increasingly congested part of the northwest Colorado region.
- Advance multimodal improvements by promoting transit and incorporating multimodal infrastructure along the corridor
- Address existing and immediately foreseeable operational and safety needs
- Plan and prepare for the future by phasing in multimodal improvements that respond to anticipated growth
- Complement existing and planned infrastructure that benefits the multimodal system and addresses system deficiencies
- Leverage joint development opportunities
- Provide equity across the corridor by distributing project advancements fairly across the corridor
CO 7 City of Boulder Roadway Improvements
Project limits: 28th Street to 33rd Street
Schedule: Construction complete in 2027
Improvements: Constructing multimodal improvements (bike, pedestrian, transit)
CO 7 and Coal Creek
Project limits: Coal Creek Boulevard Intersection
Schedule: Construction complete in spring of 2026
Improvements: Drainage improvements, box culvert replacement, water quality basin, shoulder widening
CO 7 Between Sheridan and I-25
Project limits: Sheridan Parkway to I-25
Schedule: Construction complete in spring of 2026
Improvements: Widen to four-lanes, restriping
CO 7 Resurfacing Between I-25 and US 85
Project limits: I-25 to US 85
Schedule: Construction completed in August 2025
Improvements: Asphalt, milling, paving, guardrail work
Project limits: I-25 at the CO 7 Junction (Exit 229)
Schedule: Construction complete in August 2026
Improvements: Adding sidewalks, replacing traffic signals, building a park-n-ride lot in southeast corner of interchange, Installing the Permanent Water Quality pond to accommodate the future mobility hub project
Erie to Brighton
Project limits: County Line Road to US 85
Schedule: Early Design (15%) from County Line Road to US 85 is complete. Money for construction
has not been identified.
Improvements: Early design of multimodal improvements (bike, pedestrian, transit).100% design at the intersections of Holly Street, Quebec Street, York Street and Colorado Boulevard
For more information, watch our video!
95th Street Intersection
Project limits: CO 7 and 95th Street Intersection
Schedule: Design underway with construction anticipated for summer of 2026
Improvements: Two through-lanes in each direction, a dedicated eastbound bus lane, construction of multi-use paths, improved transit facilities, various pedestrian and signal improvement
CO 7 City of Boulder Roadway Improvements from 28th Street to 63rd Street
Project limits: 28th Street to 63rd Street
Schedule: Early Design (15%) from 28 Street to 63 Street is complete. Final design will be completed by 2027. Money for construction has not been identified.
Improvements: Early design of multimodal improvements (bike, pedestrian, transit)
CO 7 City of Boulder Roadway Improvements from 28th Street to Foothills Parkway
Project limits: 28th Street to Foothills Parkway
Schedule: Final design (100%) will be completed in 2026/2027.
Improvements: Final design of multimodal improvements (bike, pedestrian, transit)
Transit Starter Service along CO 7
Official name of Starter Service is the Brighton to Boulder Flyer... Be on the lookout in Spring of 2026 for bus service along CO 7!
What is a Transit Starter Service?
Boulder County received a Federal Transit Administration grant to implement a transit starter service program from Boulder, Colorado to Brighton, Colorado. The program is intended to prove a need for transit service along an existing corridor that is lacking.
The Transit Starter Service route is set to include around 10 stations over 26.6 miles, serving communities within Boulder, Broomfield, and Adams counties and is expected to connect with other regional and interregional transit routes including:
- Flatiron Flyer
- FLEX
- Bustang
- US 287 Mobility Hub
- CDOT North I-25 Mobility Hub
